Verify a Smart Contract using the Rootstock Explorer

Contract verification is essential in the Rootstock ecosystem. It allows Rootstock Explorer users to inspect and validate the source code of deployed smart contracts.

The Rootstock Explorer provides a transparent view of the Rootstock blockchain, showing transactions, blocks, and deployed contracts. This transparency, enabled by verification, builds trust and understanding in decentralized applications.

Tip

See Rootstock Explorer guides to navigate the explorer and submit dApps.

Key reasons for verifying a smart contract

  • Builds trust:
    • Verification allows anyone to see the source code of a deployed smart contract, which fosters trust with users and the community.
  • Increases transparency:
    • Users can audit the code to confirm it performs the actions it claims to, providing confidence in the contract's operations.
  • Aids in security:
    • By making the code public, it can be reviewed for vulnerabilities, though users should still conduct their own security assessments.
  • Enables proper tooling:
    • Many development and analysis tools, such as those from Tenderly, require the contract's source code to be verified to function correctly.
  • Provides public interaction:
    • Verification allows users to interact with the contract on the Rootstock Explorer.
  • Confirms code integrity:
    • The verification process proves that the bytecode on the blockchain was generated from a specific, known source code, ensuring the contract hasn't been tampered with.
  • Helps with compliance:
    • Verification is essential for meeting certain compliance and regulatory requirements.

What does verification do?

  • Adds a Verified badge to the contract page, confirming that the published source code matches the deployed bytecode.
  • Enables human-readable interaction with the contract. It allows users to view and call its functions directly.
  • Allows downloading the contract's Application Binary Interface (ABI).

Prerequisites

  • Address of the deployed contract on Rootstock.
  • Complete source code of the contract.
  • Compiler details:
    • Solc (Solidity Compiler) version.
    • Number of optimization runs.
  • Constructor parameters (if applicable).
  • Library addresses (if used).

Getting Started

init

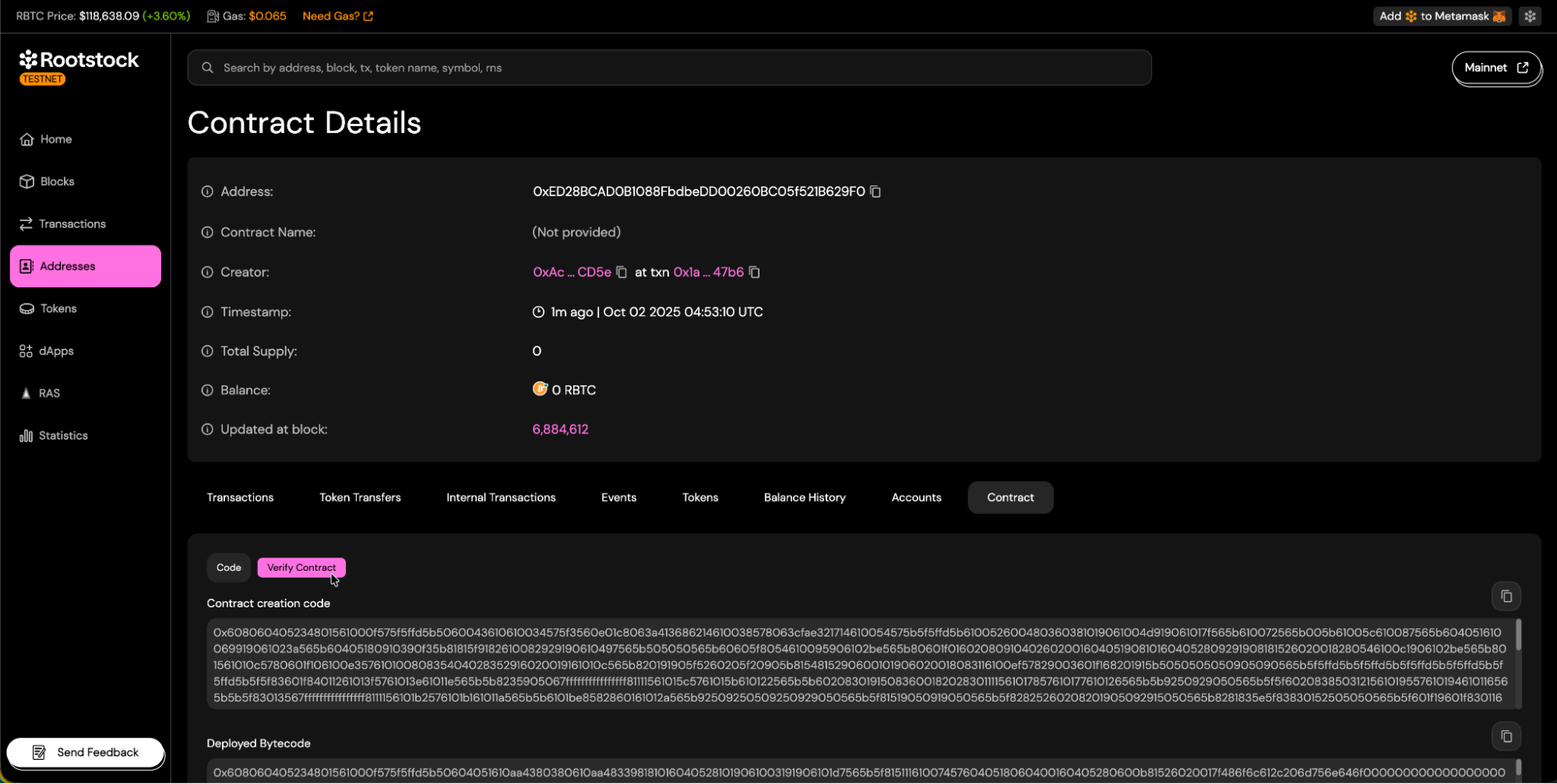

  • Once you reach your contract's address view, navigate to the "Contract" tab and click the "Verify Contract" button.

verify

Choosing a Verification Method

Rootstock Explorer offers 5 main methods for contract verification:

1. Single File

The Solidity (Single File) method is intended for verifying contracts that exist entirely within a single .sol file, or where the developer has already flattened all imports into one file. This method recompiles the provided contract and compares the resulting bytecode to the deployed contract on Rootstock.

Follow the steps below to successfully complete the verification process.

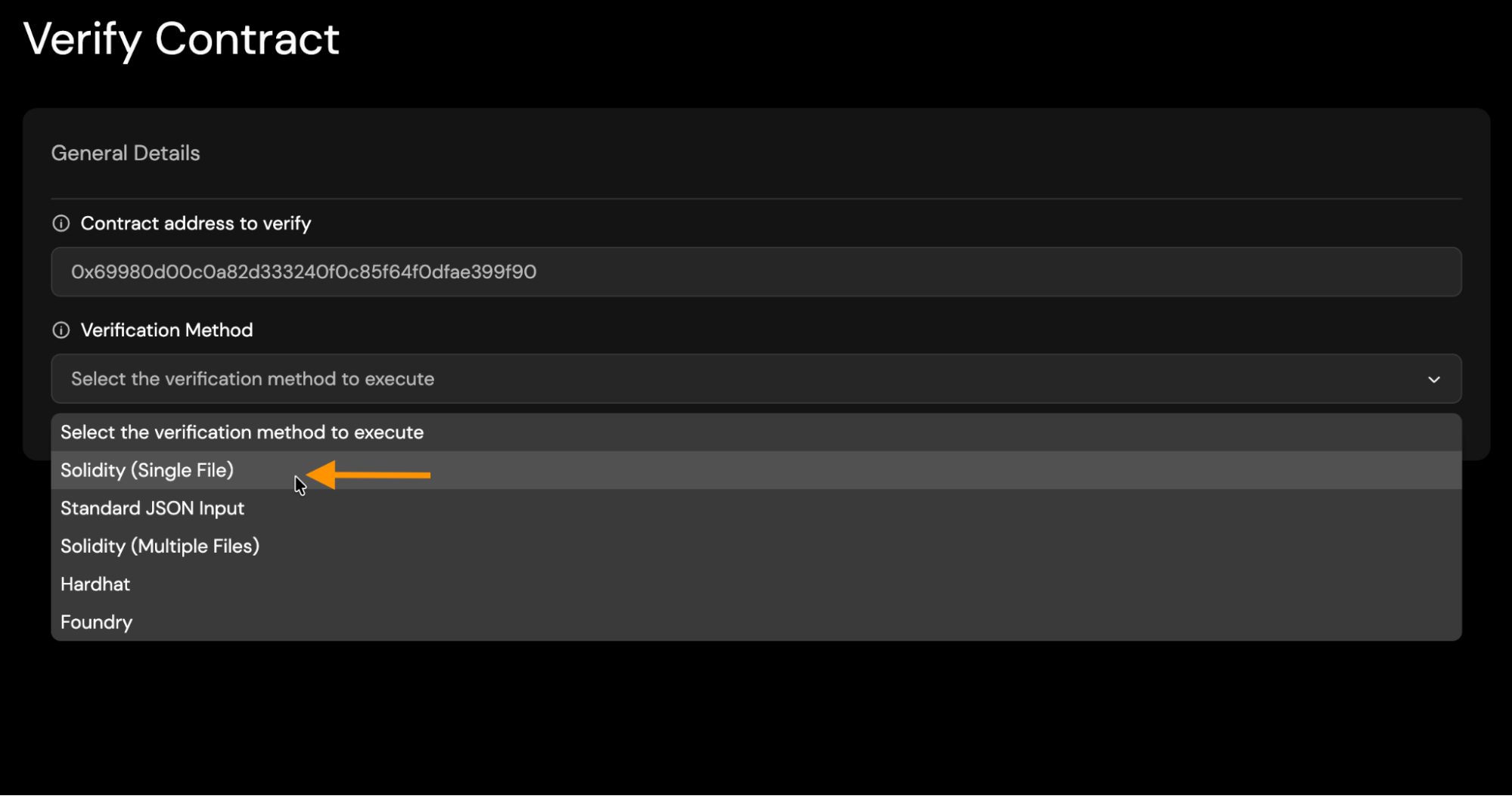

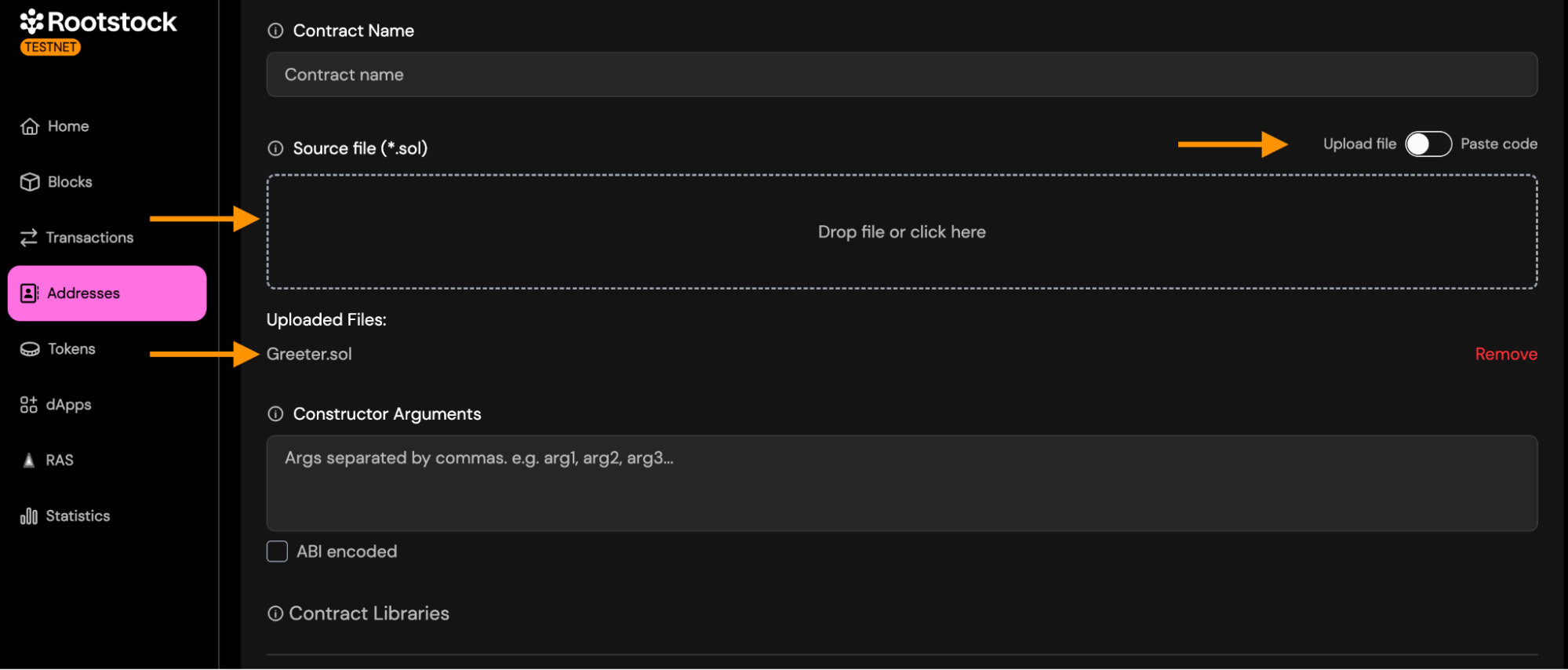

  • Select Solidity (Single File) Method: single

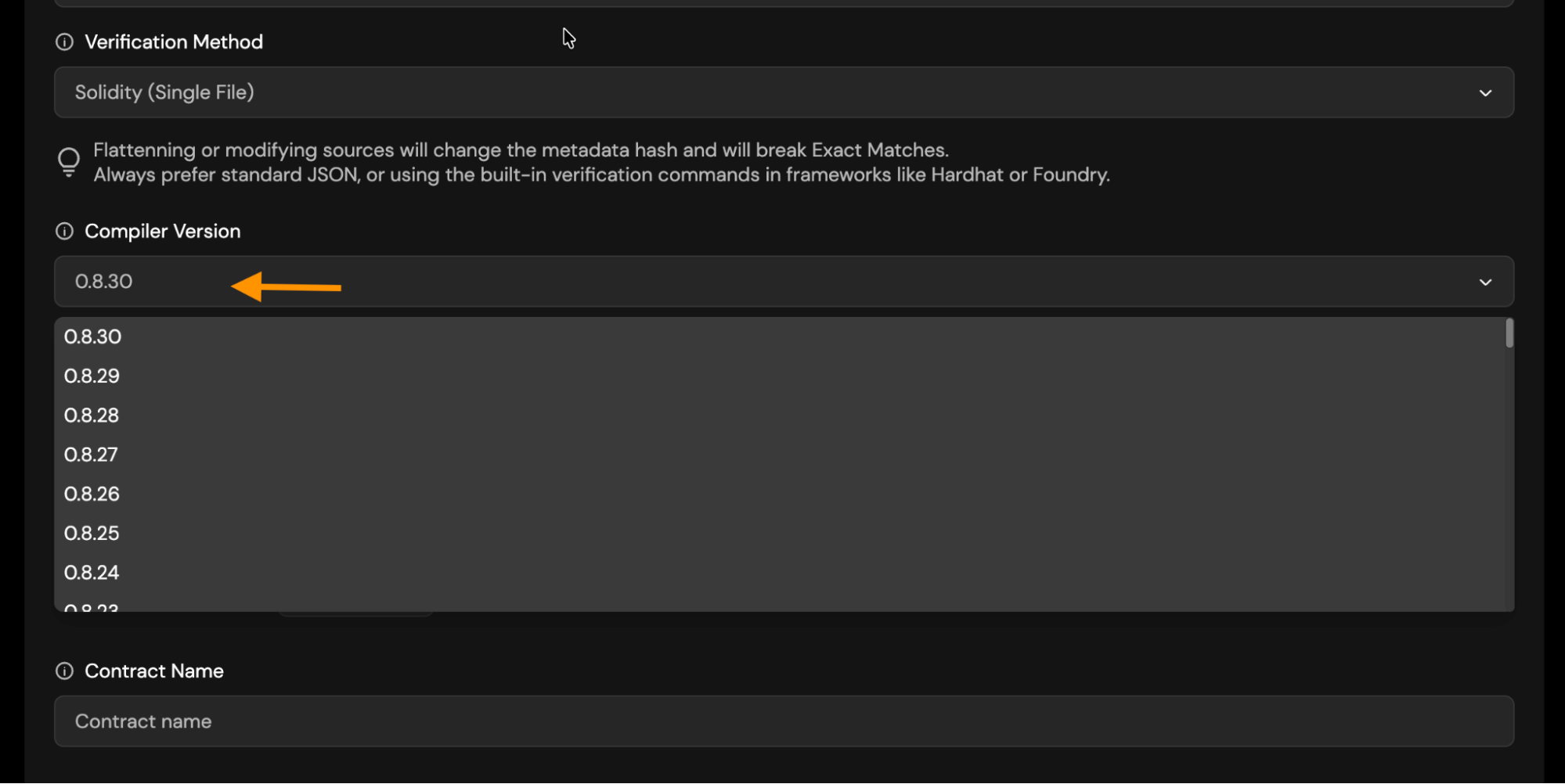

  • Solc Version: Choose the Solc version you used to compile your contract. version

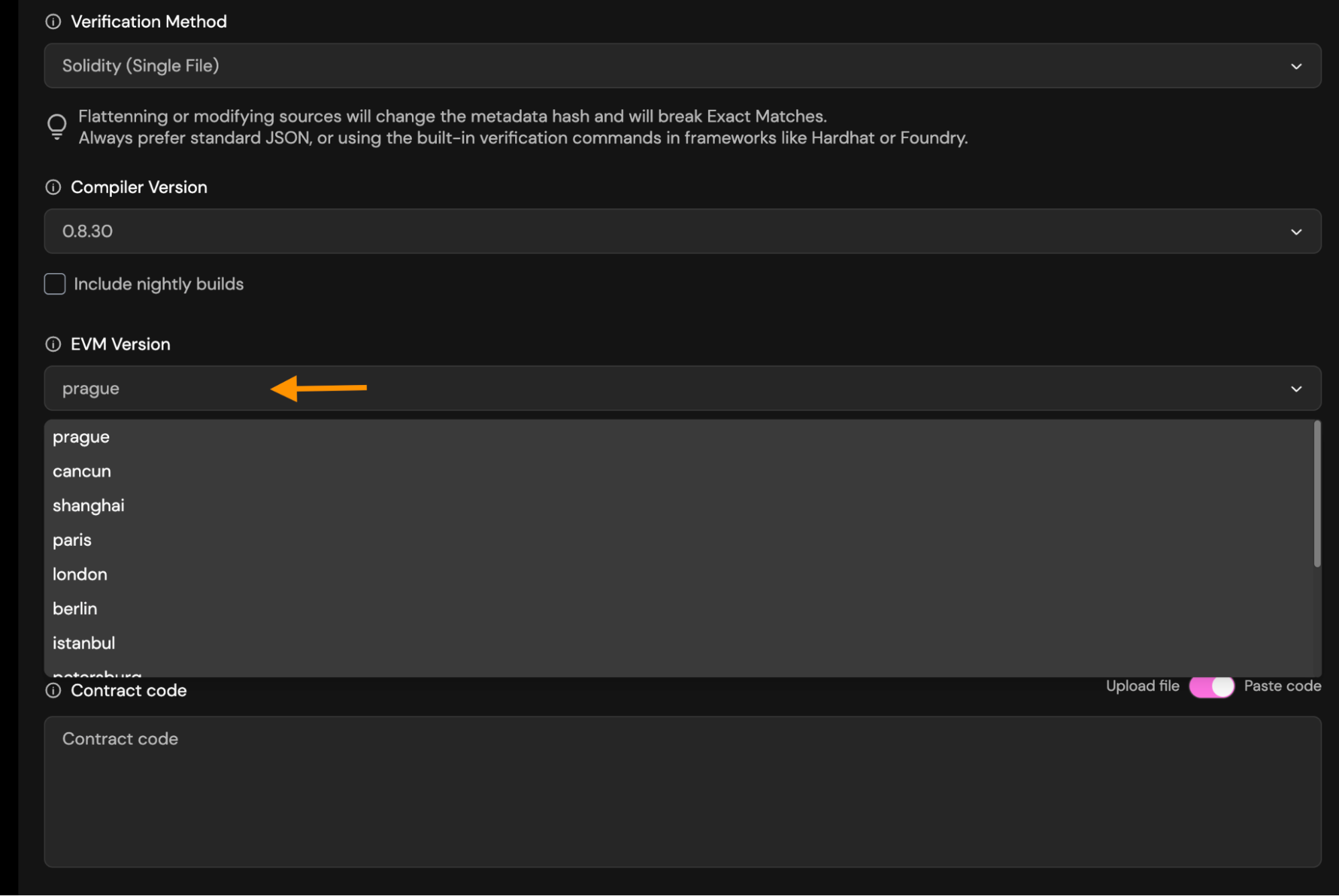

  • EVM Version: Choose the appropriate EVM version. evm

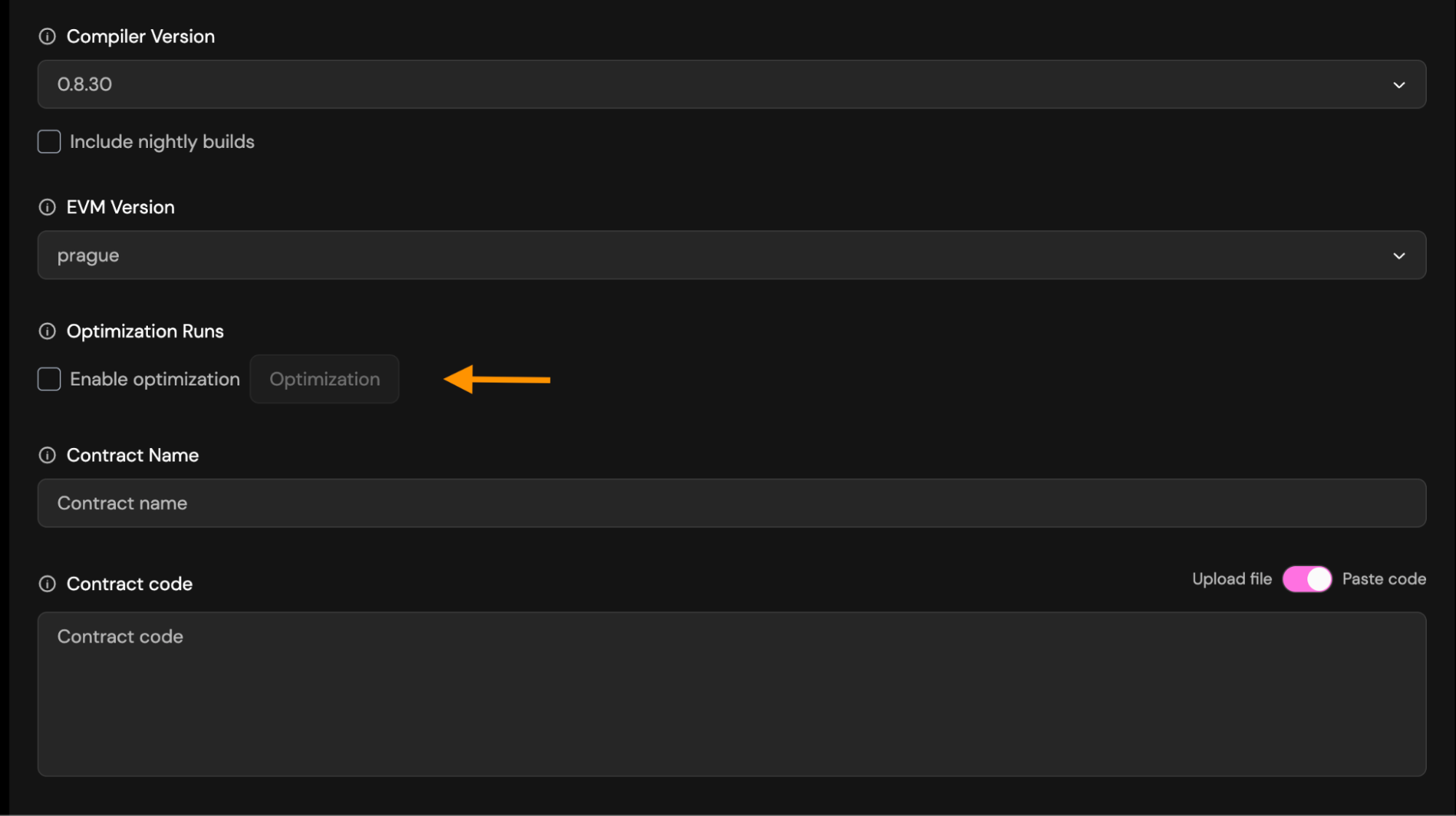

  • Optimization: Runs tells the Solidity optimizer how many times your contract will be executed. You must use the same runs value in verification that you used when compiling.

    • If you used optimization run when compiling/deploying, enable it during verification and set the same runs (default 200).
    • If you didn't use optimization, leave it disabled and don't enter any runs.

    runs

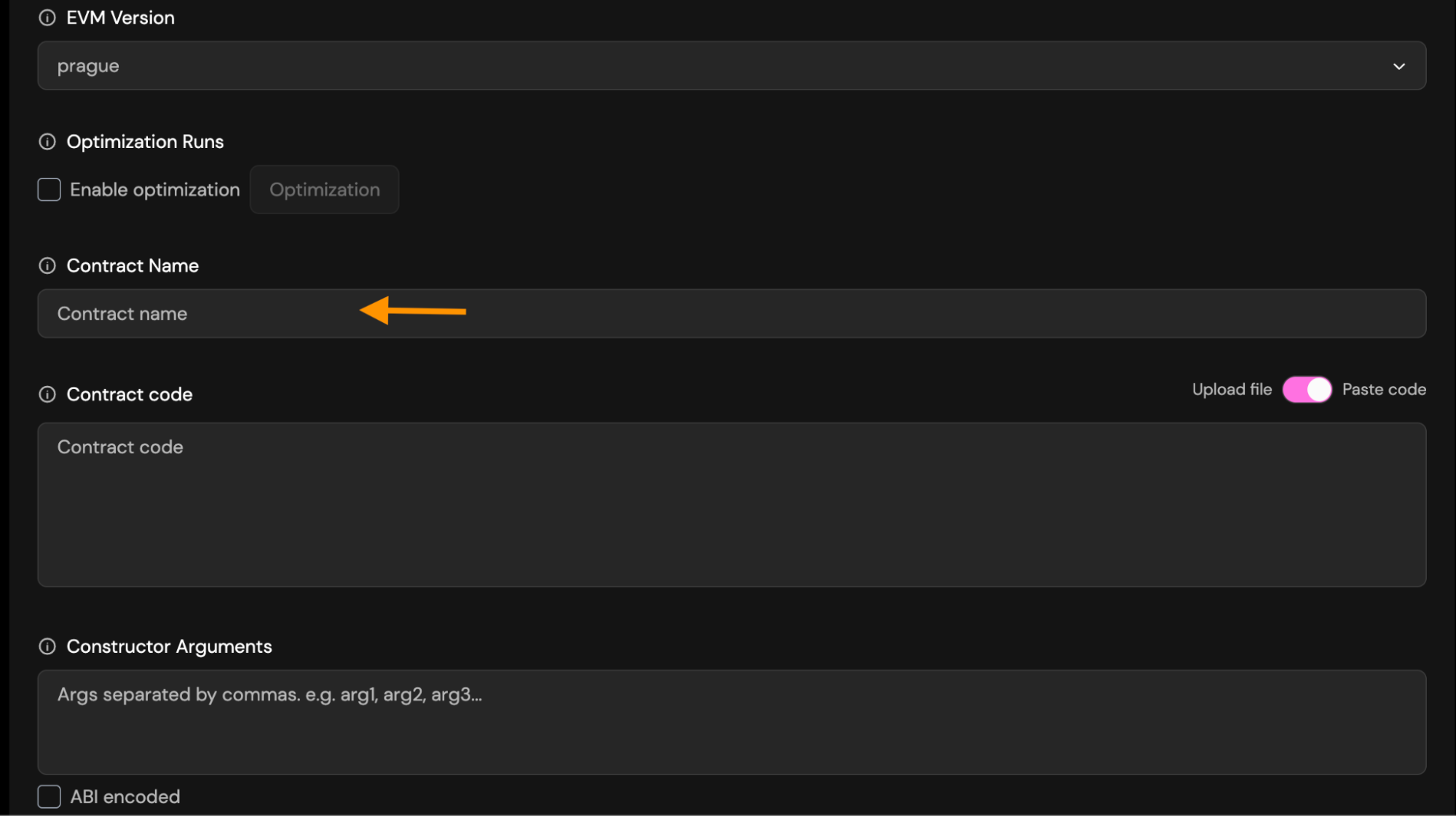

  • Contract Name: Enter the exact name of the contract you deployed. This is required so the verifier can match the correct bytecode. name

  • Paste/Upload source code: Provide the full Solidity source file.

    You may choose between:

    • Paste code: Paste the raw contract source code into the field. This must be the exact source used during deployment. code

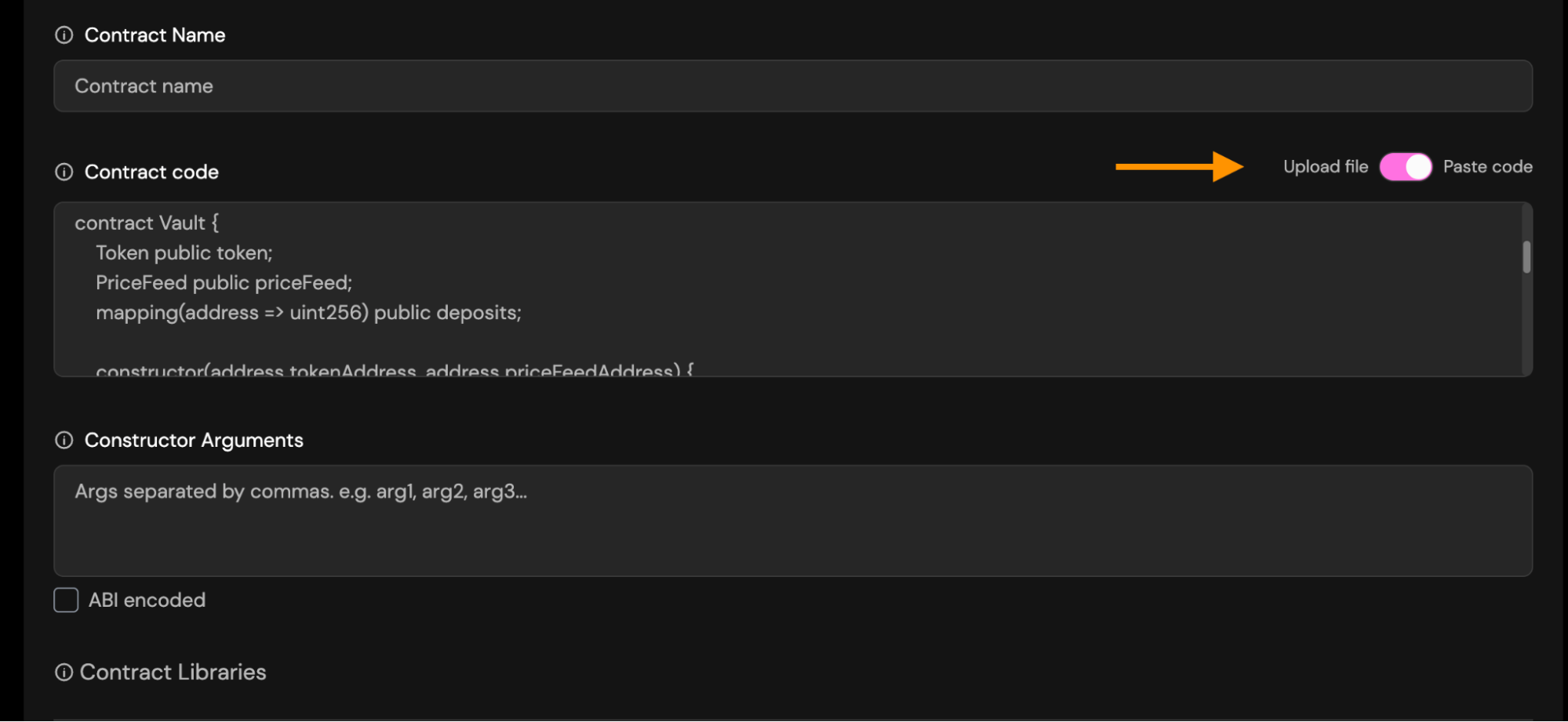

    • Upload file: Upload a .sol file directly from your computer. sol

  • Constructor Arguments: You must enter constructor arguments separated by commas if you have more than one.

    • Suppose your Solidity constructor looks like this:
    constructor(address owner, uint256 maxSupply)
    • To verify the contract, enter the arguments like this:
    0xACa52b1Ab7dA04532127d22D47Dc3d34CFe0Cd5e,1000

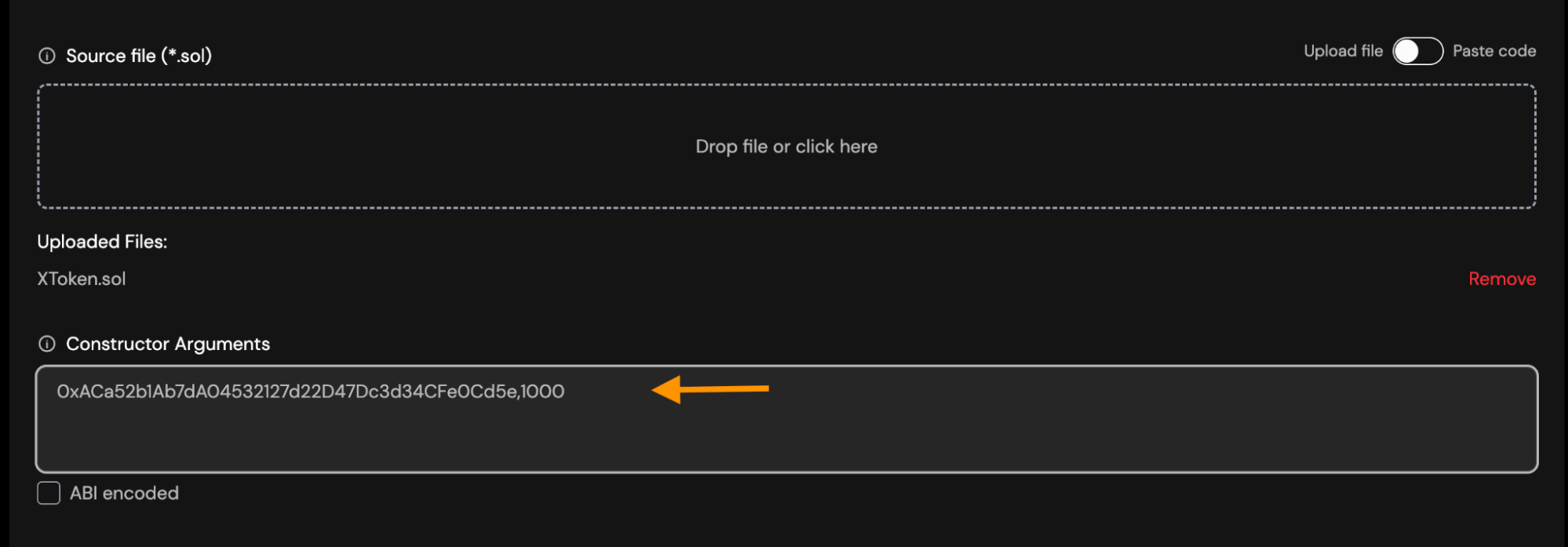

    Example: args

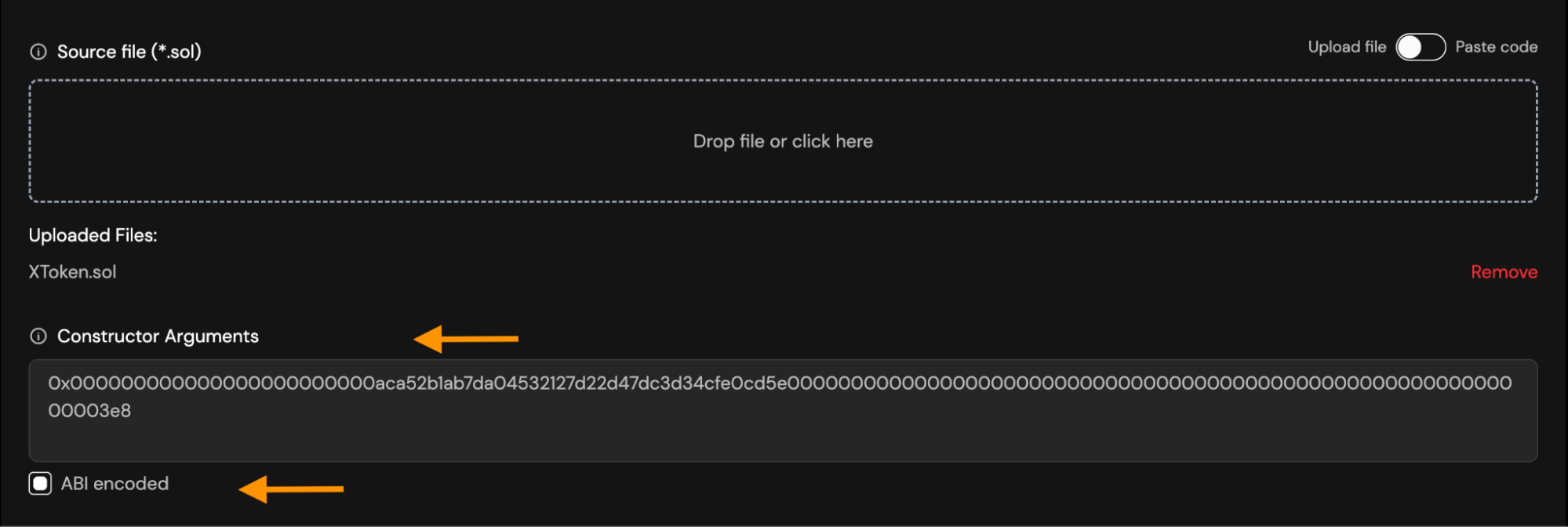

    • If you already have them in ABI-encoded format, enable the "ABI encoded" checkbox and paste the encoded string instead.

    encoded

  • How to encode arguments:

    • ABI-ENCODING with Ethers.js
    import { AbiCoder } from "ethers";

    const coder = AbiCoder.defaultAbiCoder();

    const encoded = coder.encode(
    ["address", "uint256"],
    ["0xaca52b1ab7da04532127d22d47dc3d34cfe0cd5e", "1000"],
    );

    console.log(encoded);

    Result:

    0x000000000000000000000000aca52b1ab7da04532127d22d47dc3d34cfe0cd5e00000000000000000000000000000000000000000000000000000000000003e8
    • ABI-ENCODING from Remix:
      • Open the Remix console
      • Paste the following into the console:
    web3.eth.abi.encodeParameters(
    ["address", "uint256"],
    ["0xaca52b1ab7da04532127d22d47dc3d34cfe0cd5e", "1000"],
    );

    Result:

    0x000000000000000000000000aca52b1ab7da04532127d22d47dc3d34cfe0cd5e00000000000000000000000000000000000000000000000000000000000003e8
    • ABI-ENCODING with Foundry (cast):
    cast abi-encode "constructor(address,uint256)" \
    0xaca52b1ab7da04532127d22d47dc3d34cfe0cd5e 1000

    Result:

    0x000000000000000000000000aca52b1ab7da04532127d22d47dc3d34cfe0cd5e00000000000000000000000000000000000000000000000000000000000003e8

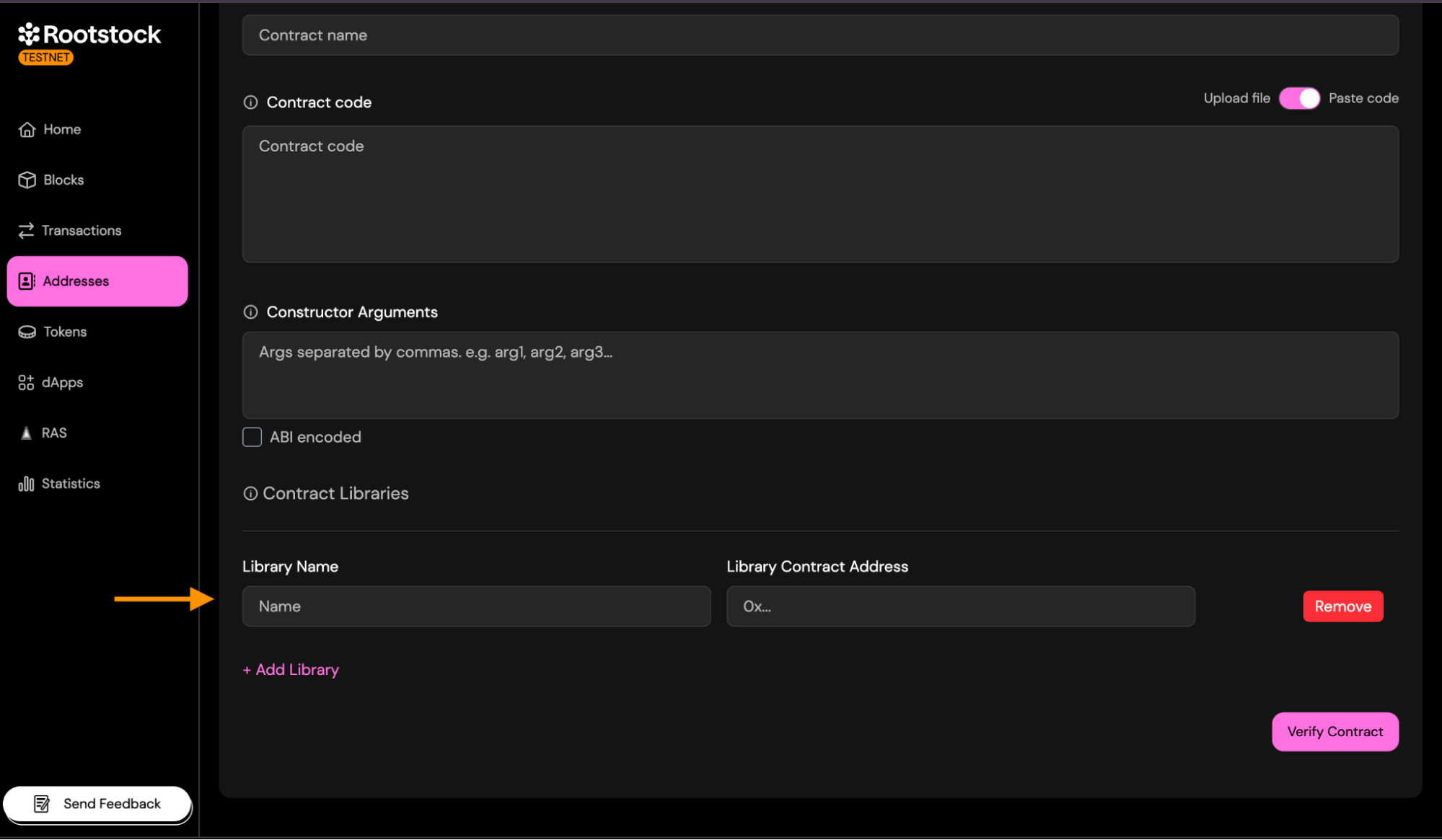

  • Libraries: If your contract links external libraries add each required library.

    Provide:

    • Library Name.
    • Library Contract Address (the address where the library was deployed).

    This step is required only if the compiled bytecode contains libraries.

lib

2. Multiple Files

The Solidity (Multiple Files) method is designed for more complex contracts that use imports, have multiple .sol files, or cannot be flattened safely. This method allows you to upload all your Solidity source files exactly as they exist in your project.

Only the parts that differ from Single File are described below.

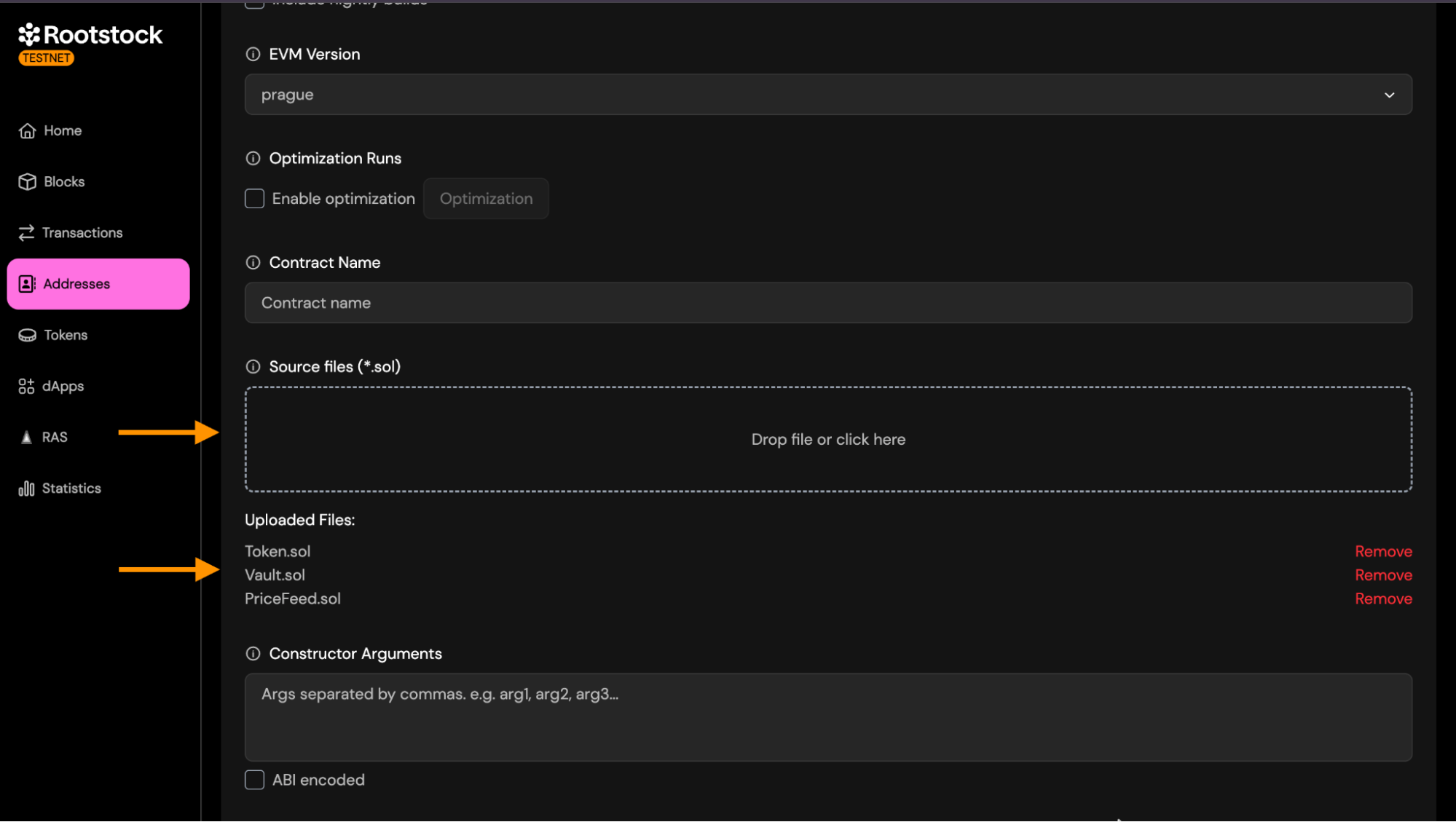

  • Source Files: Upload all Solidity files required to compile your contract, preserving the original folder structure.

You can:

  • Drag and drop multiple .sol files.
  • Upload an entire folder containing your contracts.
  • Combine both approaches if needed.

Important rules:

  • Every imported file must be included.
  • Filenames must match exactly (case-sensitive).
  • Folder structure should reflect your project layout.
  • Do not flatten the files. This method expects multi-file compilation.

During verification, the explorer will reconstruct the compilation environment using the files you provide.

multiple

  • Other Settings: All other fields (compiler version, EVM version, optimization, contract name, constructor arguments, libraries) work exactly the same as described in the Single File section.

3. Standard JSON

The Standard JSON Input method is the most reliable and exact verification approach. It reproduces the full Solidity compiler configuration used during deployment by providing a complete standard-json object, exactly as consumed by solc --standard-json.

This method is strongly recommended for:

  • Projects compiled with Hardhat, Foundry, Truffle, or custom build scripts.
  • Contracts with complex dependency structures.
  • Projects where preserving metadata (AST, settings, compiler options) is essential.
  • Ensuring a byte-for-byte deterministic match with the deployed bytecode.

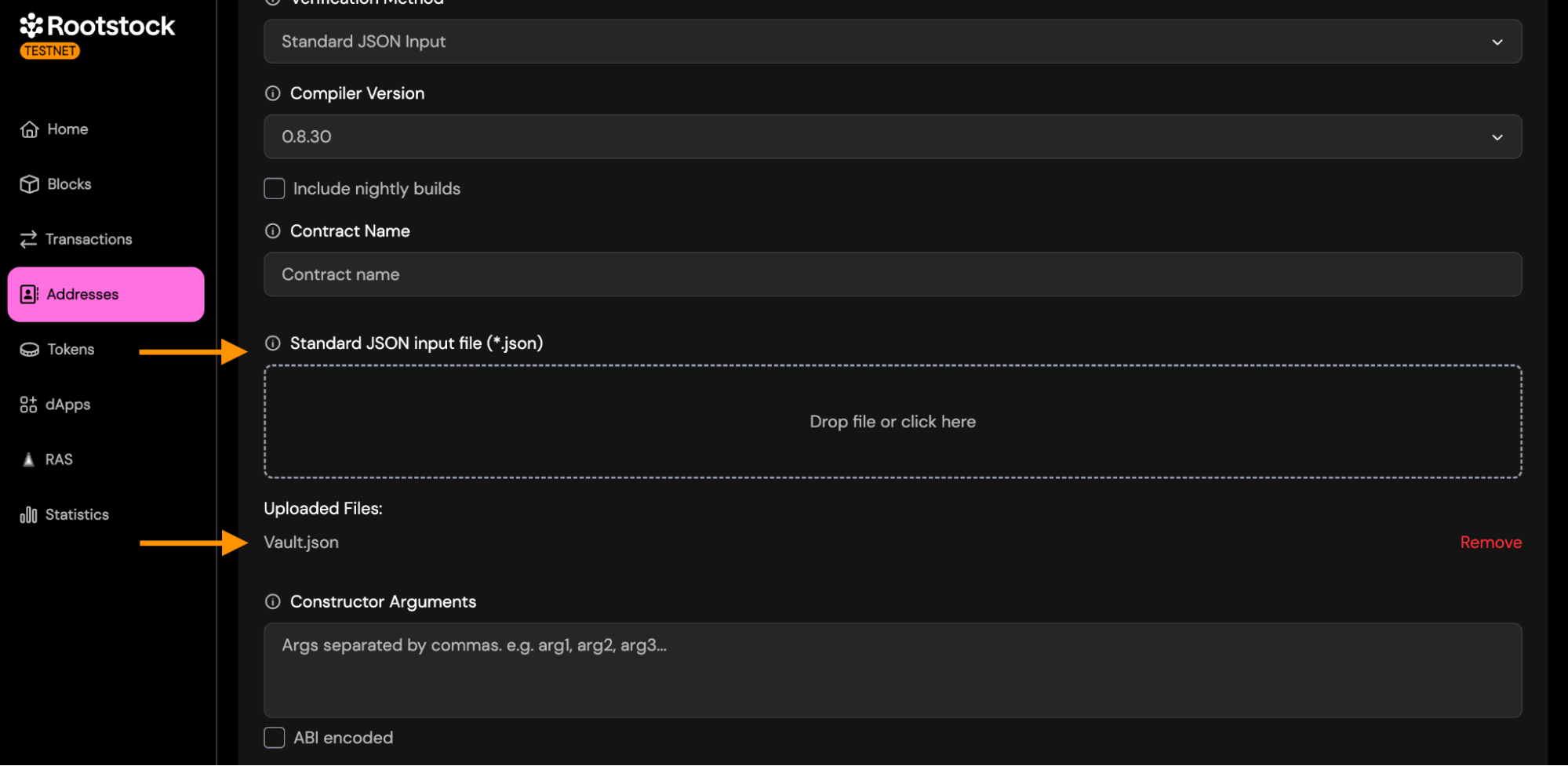

json

  • Other Settings: All other fields (compiler version, optimization, contract name, constructor arguments, libraries) work exactly the same as described in the Single File section.

How to Generate Standard JSON Input

Hardhat:

npx hardhat compile --show-stack-traces

Then locate the Hardhat build-info file under artifacts/build-info/*.json; this file contains the Standard JSON compiler input in its input field.

  • How to Extract the Standard JSON Input:

    After generating the file from Hardhat:

    • Open the JSON file that was produced.
    • Inside it, locate the field named "input".
    • Copy everything inside the input object. This is the actual Standard JSON Input expected by the verifier.
    • Paste it into a new file, and save it using the contract's name.
    • Your file should look similar to the following structure:
{
"language": "Solidity",
"sources": {
"Token.sol": {
"content": "..."
},
"PriceFeed.sol": {
"content": "..."
},
"Vault.sol": {
"content": "..."
}
},
"settings": {
"optimizer": {
"enabled": false,
"runs": 200
},
"outputSelection": {
"*": {
"": ["ast"],
"*": [
"abi",
"metadata",
"devdoc",
"userdoc",
"storageLayout",
"evm.legacyAssembly",
"evm.bytecode",
"evm.deployedBytecode",
"evm.methodIdentifiers",
"evm.gasEstimates",
"evm.assembly"
]
}
},
"remappings": [],
"evmVersion": "london"
}
}

Foundry:

forge verify-contract \
--chain-id 31 \
--watch \
--compiler-version <compiler-version> \
--show-standard-json-input \
<contract-address> \
<contract-file>:<contract-name> \
> <contract-name>.json

Replace:

  • <contract-address> → the deployed contract address.
  • <contract-file> → path to the Solidity file inside your project.
  • <contract-name> → name of the contract inside that file.
  • <compiler-version> → the Solidity compiler version used to compile and deploy the contract (for example, v0.8.28).

The > <contract-name>.json at the end of the command redirects the Standard JSON input output into a file in the current directory, which can then be uploaded as-is to the Rootstock Explorer verification tool.

4. Hardhat Verification

Select Hardhat as your verification method to verify contracts directly from your Hardhat project. This method does not require uploading files through the interface. Instead, verification is performed using the Hardhat CLI.

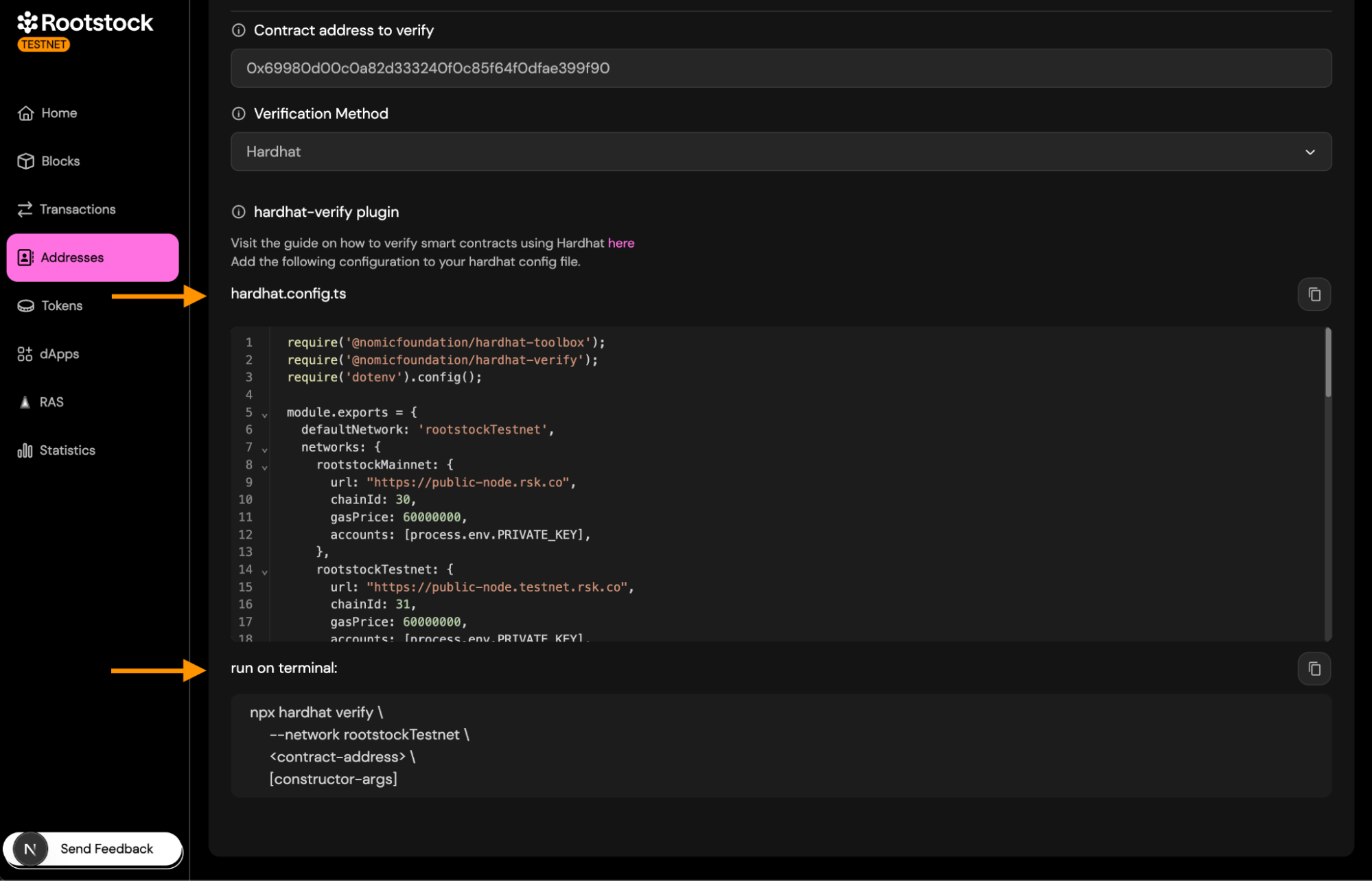

hardhat

Copy the configuration snippet into your hardhat.config.ts file.

This snippet includes:

  • The Hardhat Verify plugin
  • Rootstock Testnet/Mainnet RPC URLs
  • Chain IDs
  • Account setup for signing requests

Make sure your PRIVATE_KEY is defined in your .env file.

Run the verification command in the terminal:

npx hardhat verify \
--network rootstockTestnet \
<contract-address> \
[constructor-args]

Replace:

  • <contract-address> with your deployed contract address
  • [constructor-args] with constructor parameters (if any)

Once it completes successfully, your contract will be verified on the Rootstock Explorer.

For a detailed walkthrough, see Verify Smart Contracts using the Hardhat Verify Plugin.

5. Foundry Verification

Select Foundry as your verification method to verify contracts using the forge verify-contract command.

This method integrates Foundry directly with the Rootstock Explorer's verification API, allowing you to verify a deployed contract from your local environment.

Run the verification command in the terminal:

forge verify-contract \
--chain-id 31 \
--watch \
--compiler-version <compiler-version> \
--verifier custom \
--verifier-url https://be.explorer.testnet.rootstock.io/api/v3/etherscan \
<contract-address> \
<contract-file>:<contract-name>

Replace:

  • <contract-address> → the deployed contract address.
  • <contract-file> → path to the Solidity file inside your project.
  • <contract-name> → name of the contract inside that file.
  • <compiler-version> → the Solidity compiler version used to compile and deploy the contract (for example, v0.8.28).

Once the command finishes, your contract will appear as Verified on the Rootstock Explorer.

For a detailed walkthrough, see Verify Smart Contracts using Foundry.

Submit and Validate

Once you have entered all the details, click "Verify Contract".

  • Expected statuses: The verification status will change from "Pending" to "Success" or "Failure".

  • On successful status:

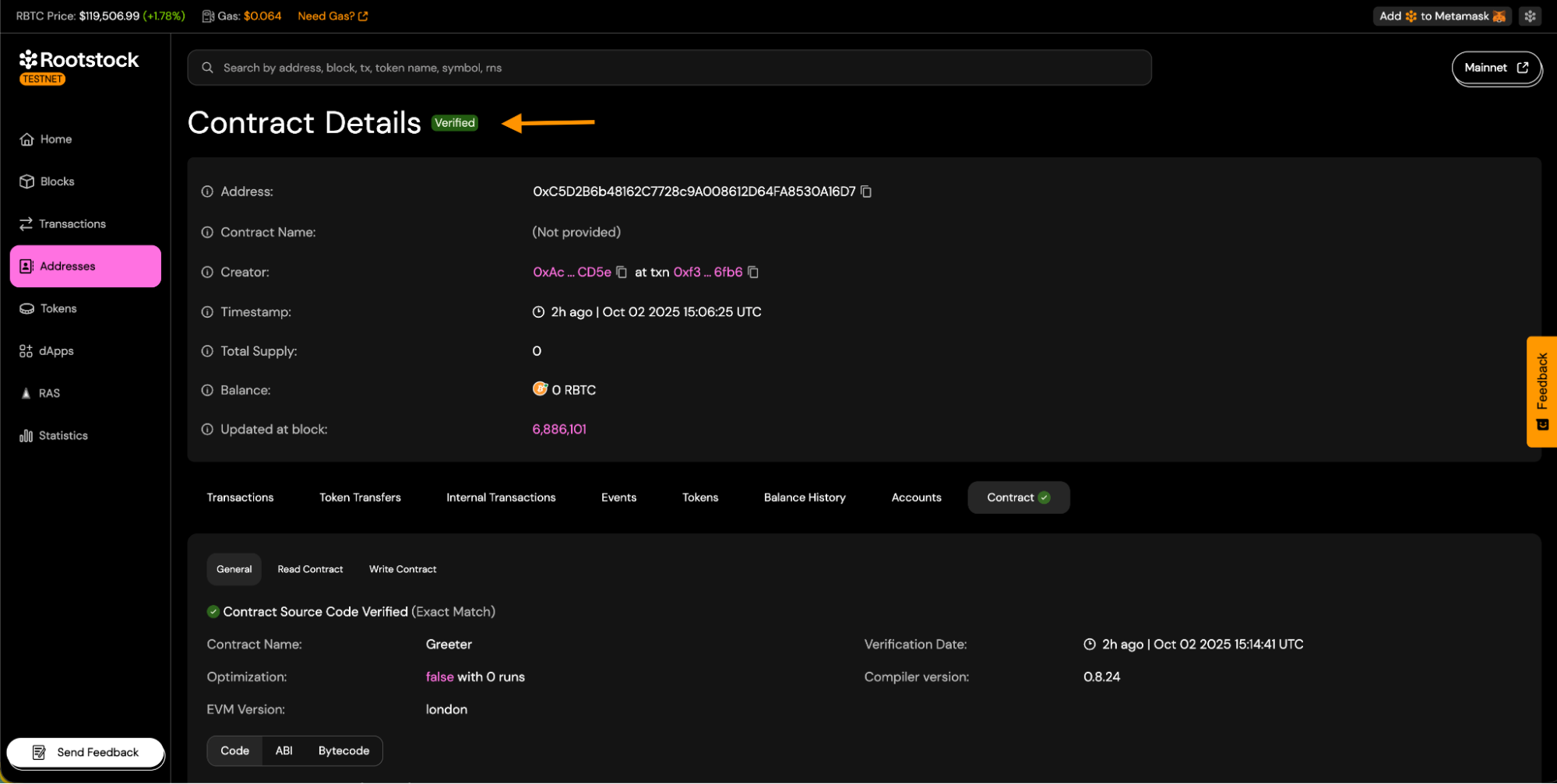

    a. You will see the Verified badge on the contract page. verified

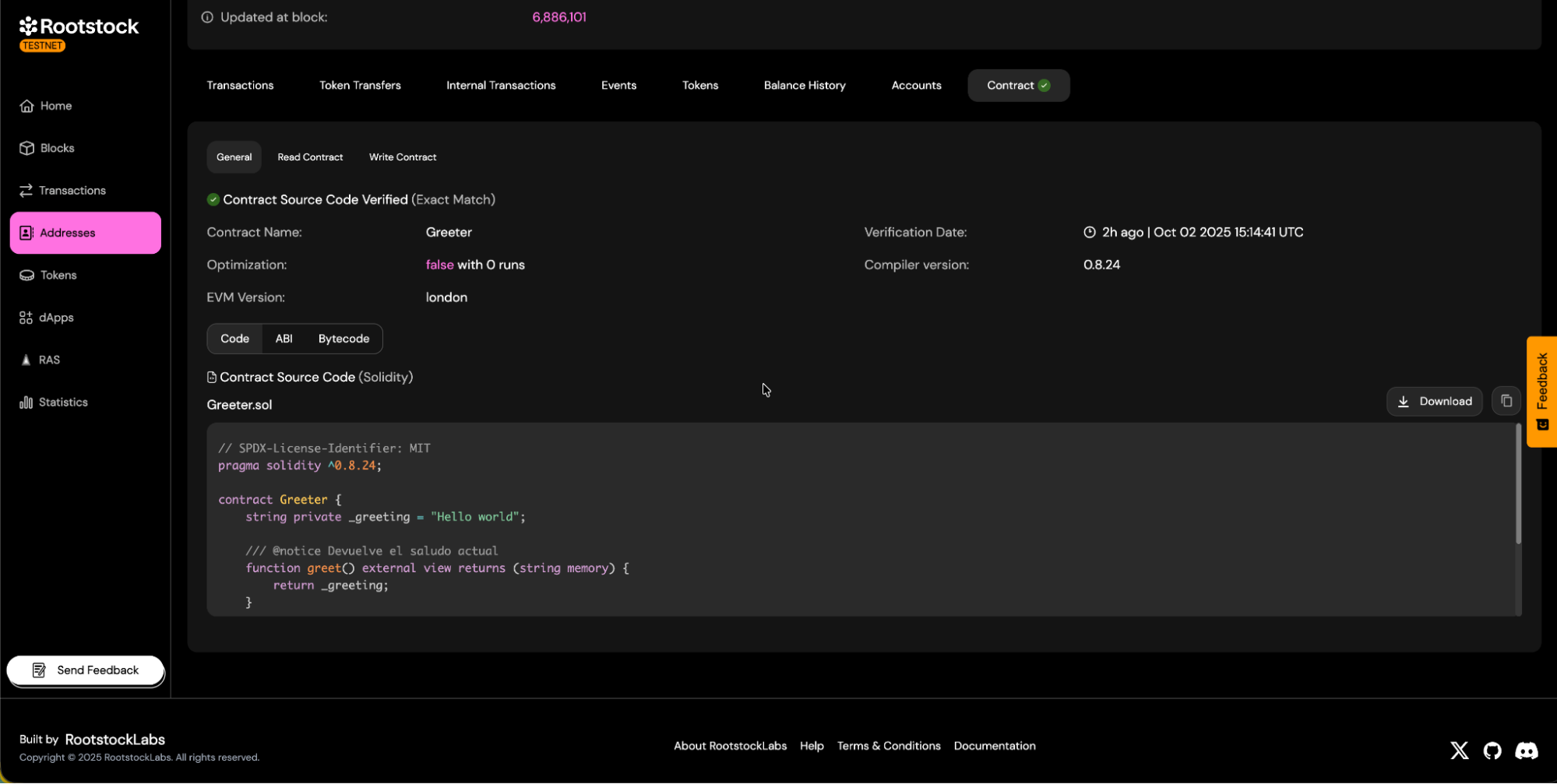

    b. Source code tabs will be visible. tabs

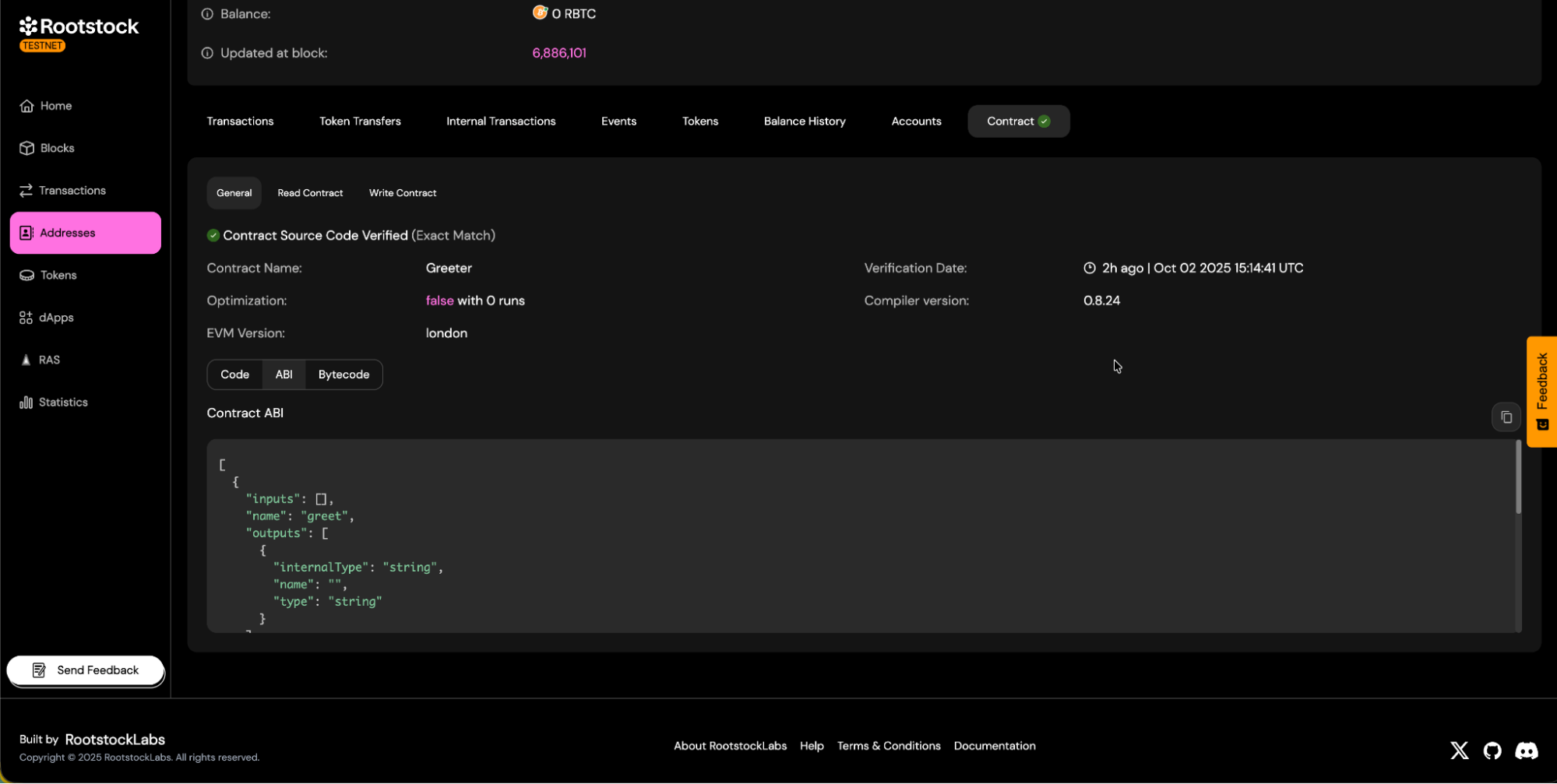

    c. You will be able to download the contract ABI. abi

    d. Contract read and write panels will be available.

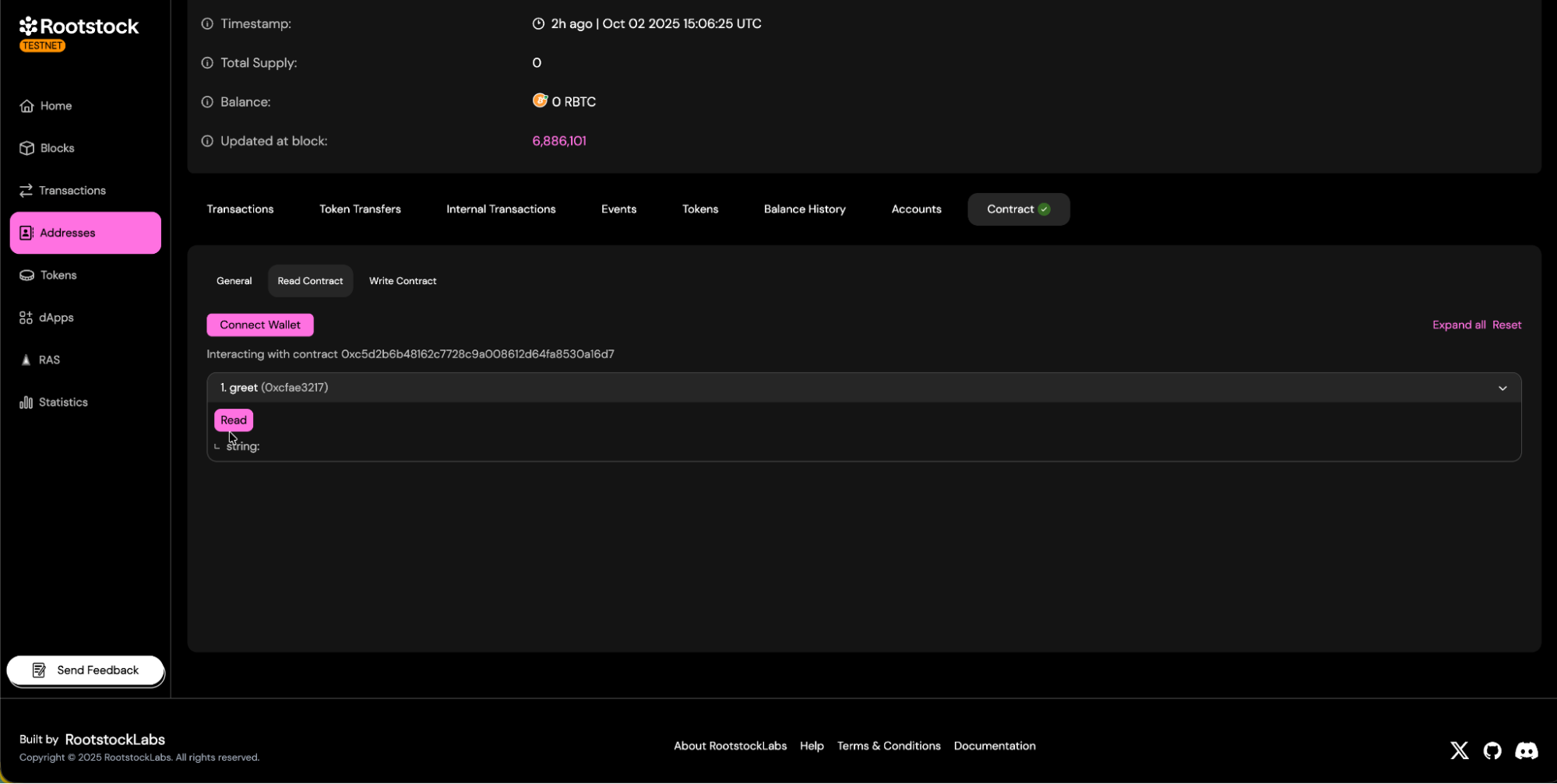

    • Read Methods: contract-interaction
    • Write Methods: write

Troubleshooting

  • Here are some common errors and their solutions:

  • Confirm the exact Solc version used to compile your contract.
  • Retrieve the version from your compilation artifacts.

  • Verify the precise encoding, order, and types of your constructor arguments.

  • Ensure library names match bytecode placeholders.
  • Add the correct deployed addresses for each library.

  • Align the number of optimization runs with your compilation settings.

  • Consider using the Standard JSON verification method to avoid path or flattening issues.

  • Verify the implementation contract.
  • Note any proxy-aware UI (if available) and how to link it.
Tip

If verification keeps failing, try matching the compiler settings directly from your Hardhat or Foundry build artifacts.

Resources
